Storage Skid Systems for Liquid Storage & Transfer
Bring liquid storage, refill and transfer together in one coordinated package. ChannelVessel configures tanks, pumps, piping, valves, instrumentation and controls around your usable inventory, delivery duty and site connections.
Larger storage requirements can be reviewed with larger vessels, multiple tanks or separate tank-and-transfer modules.

Choose the Right Storage and Transfer Configuration
Start with the operating task, then choose the equipment. Define whether the system must absorb uneven demand, supply a day tank, circulate stored liquid or keep different batches separate.
Absorb the difference between supply and demand
Use a buffer arrangement when incoming supply and downstream consumption do not follow the same pattern. Define the largest expected inventory shortfall, the time available to recover it and the conditions under which the receiving process can pause.
Choose redundancy for a reason, not by habit
One tank can be considered when inlet, outlet, level-control and product-quality conditions allow simultaneous operation.
Review separate tanks and controlled transfer paths when the incoming batch must remain isolated before use.
Check the remaining tank’s usable inventory, isolation and changeover arrangement before calling the system redundant.
Review tanks, shared piping, valves and cleaning boundaries together rather than separating only the vessels.
What Is Included in a Storage Skid System?
A storage skid coordinates the receiving connection, stored inventory and delivery equipment as one operating package. The tank provides the inventory; the surrounding equipment determines how it is replenished, monitored and supplied to the process.

Final arrangement is configured around the required storage and transfer duty.
Define how liquid enters the system
Identify whether the refill source is a road tanker, IBC, drum, bulk tank or upstream process, and confirm who provides the refill pressure and flow. The skid can receive liquid from existing equipment or include its own unloading pump when required.
The storage vessel is then configured with the required capacity, supports, process connections, level measurement and venting provisions.
Size the delivery path around the real duty
Develop the transfer path around required flow and delivery pressure. The package can include a transfer pump, isolation valves, applicable non-return protection, flow or pressure measurement and connections to one or more users.
Recirculation and drainage paths should be reviewed separately from the normal delivery route so their purpose and operating conditions remain clear.
Specify functions, not just hardware
Define local operation, automatic refill requests, pump permissions, alarms and remote signals together. A control panel should be specified by the functions it must perform, not simply by the presence of a PLC or touchscreen.
Storage Skid Specifications and Design Options
Use these options to define the quotation basis. The final proposal identifies the selected equipment, operating conditions, included features and site responsibilities.
Larger storage requirements can be reviewed with a larger vessel, multiple tanks or separate storage and transfer modules.
These are inquiry starting points, not a catalogue of interchangeable standard models. Specify capacity as gross volume, usable inventory or required supply time.
Calculate Usable Storage and Supply Autonomy
The useful sizing question is not only “How large is the tank?” It is “How much liquid can the process draw before the system reaches its minimum operating inventory?”
This relationship is a starting point for sizing when there is no incoming supply during the required autonomy period.
This diagram uses illustrative inventory limits for calculation. Final operating and protection settings are project-specific.
How long can a 20 m³ tank supply the process?
Assume a gross volume of 20 m³, a normal upper inventory of 17 m³ and a minimum operating inventory of 3 m³.
Starting from the normal upper inventory with no refill, that is approximately 9 hours 20 minutes of theoretical supply within this assumed operating window.
If the tank currently contains 8 m³, only 5 m³ remains above the 3 m³ minimum. At 1.5 m³/h, that is approximately 3 hours 20 minutes of supply.
Translate demand and autonomy into a starting tank volume
The matrix assumes an illustrative operating window from 15% to 85% of gross volume, giving a usable fraction of 70%. These are inventory fractions, not alarm settings or percentages of tank height.
| Process demand | Supply time without refill | Required usable inventory | Calculated gross volume at 70% usable fraction |
|---|---|---|---|
| 0.5 m³/h | 4 h | 2 m³ | 2.86 m³ |
| 0.5 m³/h | 8 h | 4 m³ | 5.71 m³ |
| 1.0 m³/h | 8 h | 8 m³ | 11.43 m³ |
| 1.5 m³/h | 8 h | 12 m³ | 17.14 m³ |
| 2.0 m³/h | 12 h | 24 m³ | 34.29 m³ |
Calculated volumes are engineering starting points rather than selected tank models. Normal filling limits, alarm levels and overflow protection should remain distinct when the final level schedule is defined.
Review HSE tank-storage guidanceMatch Refill Rate, Pump Duty and Inventory Recovery
Adequate tank volume does not guarantee that inventory can recover fast enough. Check replenishment while the process is still consuming liquid, then verify the transfer pump at the real delivery condition.
How quickly can the tank recover 14 m³ of inventory?
Assume the process continues consuming 1.5 m³/h while the system refills. The table shows why refill flow must be compared against simultaneous demand rather than considered on its own.
Inventory continues falling. The source cannot keep pace with demand.
The current inventory is maintained, but no storage margin is recovered.
Restoring 14 m³ takes approximately 9.33 hours.
Restoring 14 m³ takes approximately 3.11 hours.
Do not select the pump from tank capacity alone
A high published maximum-flow value does not prove that a pump will operate correctly at the installation duty. Suction conditions should be reviewed at the lowest permitted inventory, where available NPSH may be less favorable.
Review Grundfos guidance on NPSH and suction conditionsA second pump does not remove every common failure point
Define the start permission and changeover logic for a standby pump. A low tank level, blocked common suction path, unavailable power source or closed outlet can affect both pumps.
Select Wetted Materials and Temperature-Control Options
Start with the liquid, concentration, temperature and impurities, then review the complete wetted path. A tank material alone does not establish compatibility for pumps, valves, seals, gaskets and instruments.
Corrosion behavior changes with concentration, contaminants and temperature. Review the actual chemical environment rather than selecting material from the liquid name alone.
Review Outokumpu corrosion guidance
Control heat gain or loss during storage
Define the allowable temperature change and holding period. Insulation reduces heat transfer but does not actively heat or cool the product.
Specify the target, not just “jacket required”
Provide incoming and target temperatures, required conditioning time and available utilities so the required heat-transfer duty can be reviewed.
Define what the loop must accomplish
State whether circulation is intended for temperature conditioning, filtration or another function. A return line alone does not guarantee complete mixing.
Treat cleanability as a complete system requirement
Product-contact finish, drainability, connection type, cleaning method and required records should cover the tank, pump, valves and pipework together.

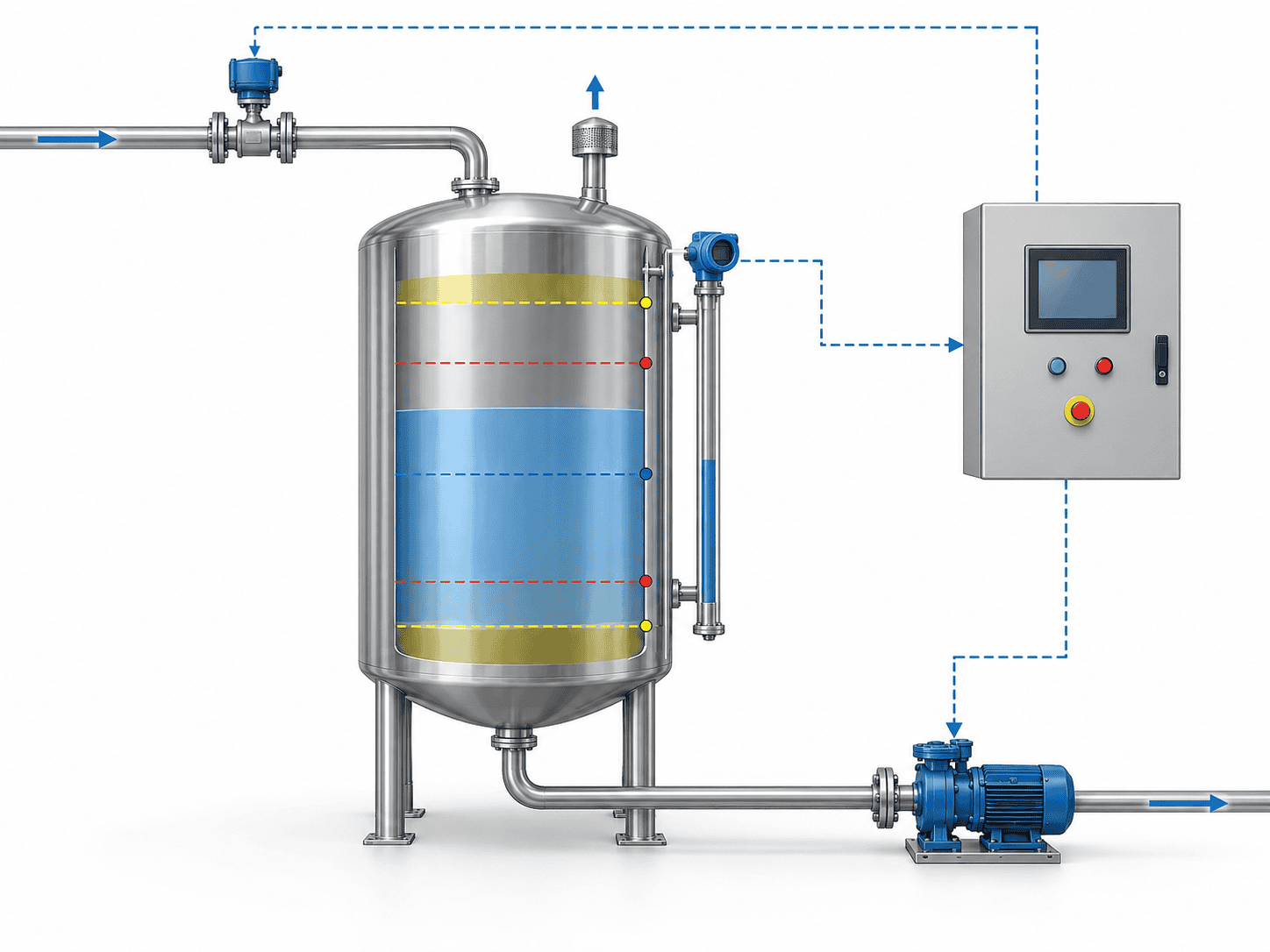

Level Control, Overfill Protection and Tank Venting
Define normal operating control separately from protective action. The control philosophy should state when filling starts and stops, when transfer is permitted, how abnormal conditions are detected and what must happen before restart.
Define the condition, then define the required response
This is a discussion example rather than final PLC logic. Final actions, independence, timing, valve positions and reset requirements should follow the project risk review.
Request replenishment after confirming source availability and receiving capacity.
Use the intended process-control function rather than relying on a high-level alarm as the normal stopping point.
Remove the pump permission or perform the specified protective action when the minimum operating condition is exceeded.
Warn that the normal refill range has been exceeded and initiate the defined operator or automatic response.
Stop incoming transfer or perform another approved protective action according to the hazard review and site philosophy.
Start a configured standby pump only when its source, suction path and downstream permissions remain valid.
Apply the required action for the affected equipment and containment arrangement rather than assuming one universal shutdown response.
Stop or isolate equipment as required while preserving any relief, venting or other safety functions that must remain available.

Liquid can continue entering after a high-high condition is detected
Assume a maximum inlet flow of 6 m³/h and 20 seconds from detection to complete cessation of inflow. Conservatively ignore simultaneous outflow.
The 33.3 L result is only the liquid arriving during the assumed response period. It is not the required final reserve and should not be used directly as an alarm-setting value.
Include filling, withdrawal, thermal effects and applicable emergency cases
Confirm the vent discharge destination and any connection to vapor recovery or treatment. A venting reference does not mean every storage skid is designed or certified to the same code.

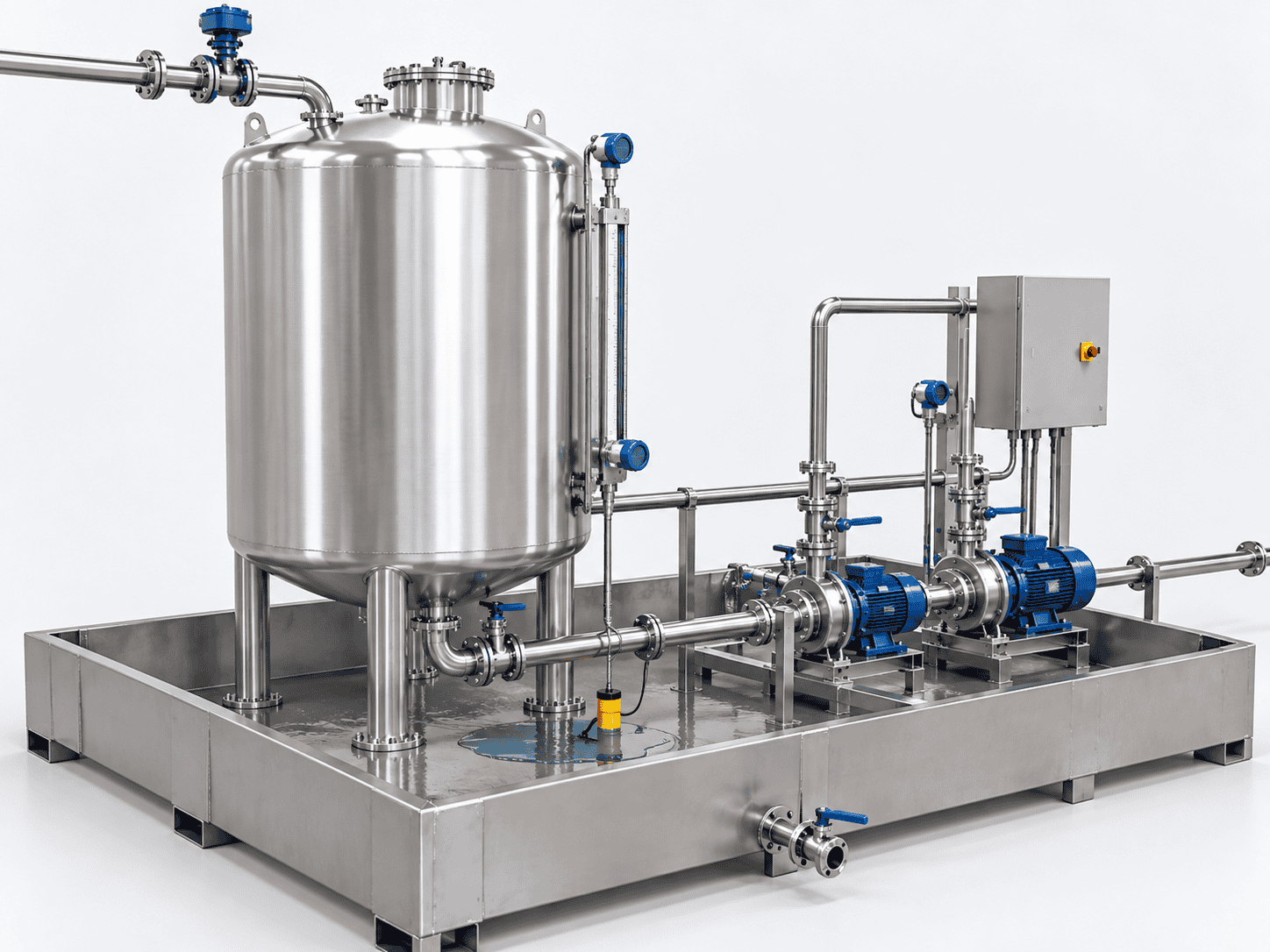

Secondary Containment, Leak Detection and Drainage
Specify the release scenario before choosing a drip tray, double-wall tank or site bund. These features do not describe the same level of protection and should not be treated as interchangeable.
Define the small leaks, maintenance drips or connection points the tray is intended to collect. A local tray does not automatically provide full-volume secondary containment.
Confirm the outer barrier, interstitial monitoring method and which nozzles, pumps or external components remain outside that secondary barrier.
Define the equipment inside the containment boundary, effective capacity, material compatibility and the controlled route for recovered liquid.

Know what is inside the protected area and where released liquid can go
Effective containment volume is not simply the geometric size of the tray or bund. Review vessel and equipment displacement, accumulated liquid, drainage controls and any precipitation allowance required by the project basis.
For applicable US oil-storage installations under SPCC, EPA guidance addresses containment for the largest single container plus adequate precipitation freeboard. Other liquids and jurisdictions require their own project basis.

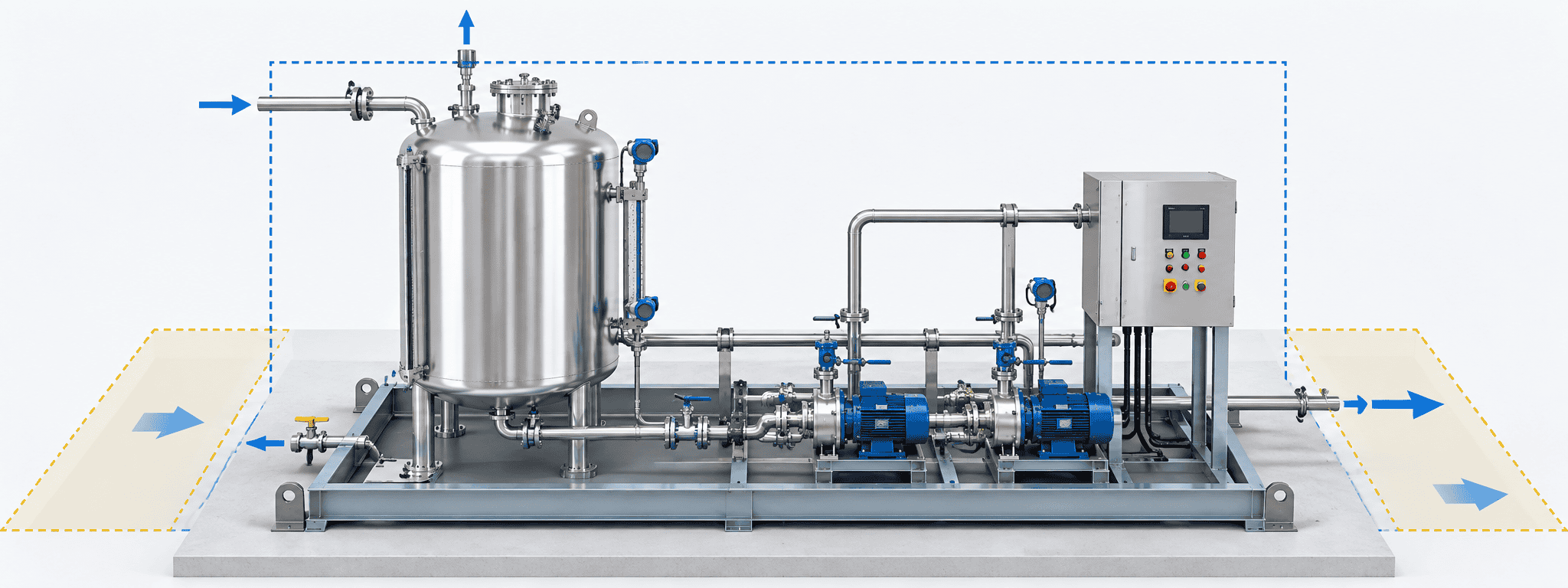

Plan Skid Layout, Transport and Site Interfaces
Confirm the installation envelope before fixing the frame. Equipment footprint, maintenance access, transport limits and site tie-ins should be reviewed together rather than treated as separate decisions.

Capacity alone should not decide the transport arrangement
Compare packed dimensions, transport route, lifting condition, maintenance access and site restrictions for an integrated tank-and-pump skid against a separate tank and transfer module.
A 30 m³ tank is not a universal dividing line. The practical layout depends on vessel geometry, total transport weight, local road limits, lifting access and the amount of equipment installed around the vessel.
Useful when the assembled package remains transportable and maintainable as one unit.
Requires clear responsibility for site piping, cabling, supports and final assembly.
Check liquid mass, not only the empty equipment weight
Using the earlier worked example, assume a normal upper inventory of 17 m³ and a liquid density of 1,200 kg/m³.
Show where the skid supply ends and the site work begins
Connection size and type, location, flow, pressure and supply responsibility.
Required destination, connection conditions and site tie-in scope.
Recovery route, discharge control and responsible party.
Voltage, frequency, isolator, incoming cable and earthing scope.
Required signals, communication method and commissioning responsibility.
Heating, cooling or instrument-air conditions where applicable.
Foundation, anchors, access, offloading and interconnecting pipework.

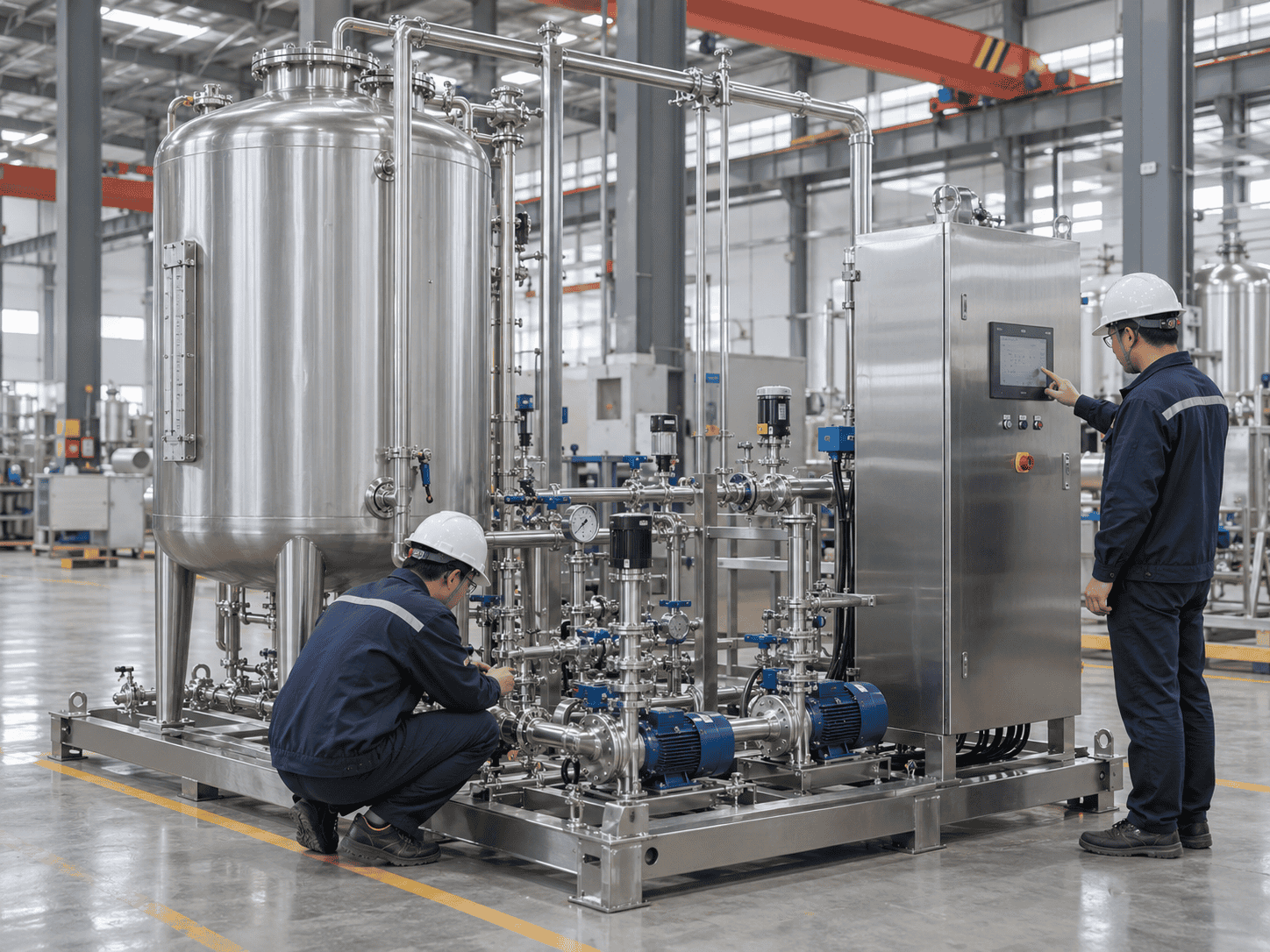

Factory Acceptance Testing and Project Documentation
Define acceptance before fabrication. The inspection and test plan should identify what will be checked, the acceptance criteria, the required records and any purchaser or third-party witness points.
Agree the applicable records and traceability level before manufacturing starts.
Check the assembled package against the approved arrangement and interface requirements.
Define the test medium, test scope and required reports rather than applying one universal test pressure.
Confirm which instruments are checked individually and which functions are demonstrated as part of the assembled system.
Use simulation where appropriate, but distinguish a simulated signal from a complete end-to-end functional test.
Record what the factory test proves and what still depends on actual process liquid or site conditions.
Close agreed punch-list items or document their disposition before shipment authorization.

State the test medium, test conditions and remaining site checks
When water is used in the factory, identify which hydraulic or functional results transfer directly and which actual-service conditions still need engineering confirmation.
A simulated input can verify control logic without proving the installed sensor, field wiring and final element as one complete loop.
External pumps, site valves, utilities or plant control systems may only be fully verified after the skid is connected at site.
Agree the records required with the equipment
The final package should reflect the purchased scope and agreed inspection requirements rather than a generic stack of documents.
Compare Storage Skid Quotes, Cost Drivers and Lead Time
Two quotations can describe the same nominal tank capacity while covering very different usable inventory, pump duty, controls, testing and site work. Compare the operating duty and supply boundary before comparing the price.
Confirm whether the quoted tank volume represents gross vessel capacity or the inventory available between normal upper and minimum operating levels.
Compare the tank, pipework, pump internals, valve trim, seals and gaskets rather than checking the vessel material alone.
A pump model or maximum-flow figure is not enough. Check the required flow, outlet pressure, fluid condition and suction basis.
Identify transfer, standby, recirculation and unloading duties separately so optional equipment does not disappear into a generic “pump package.”
Compare normal refill control, alarms, pump permissions, protective actions, remote signals and the interfaces to external equipment.
A drip tray, double-wall vessel and full secondary containment are not equivalent. Confirm effective volume, monitored equipment and drainage responsibility.
Compare the inspection plan, FAT scope, witness points, test reports and document package rather than accepting “factory tested” as a complete definition.
Clarify foundations, offloading, anchors, interconnecting pipework, power cables, utilities, commissioning and site control-system integration.
What usually changes the quotation value?
Vessel size and design conditions, material selection, pump arrangement, containment, temperature conditioning, electrical requirements, inspection scope, specialist instruments and site services can all change the equipment cost.
Ask optional items to be identified separately so you can see what is changing the price.What usually changes the delivery schedule?
Drawing approval, vessel fabrication, purchased pumps and instruments, control-panel build, inspection requirements and shipment-release activities may each affect the schedule.
Confirm whether the quoted lead time starts from order placement, drawing approval or another agreed milestone.Storage Skid Systems FAQs
These questions focus on the decisions that most often change storage capacity, system configuration, supply scope and quotation accuracy.
Usable inventory, refill availability, transfer performance and site interfaces usually matter more than the nominal tank capacity alone.
How is a storage skid different from a standalone storage tank?
A standalone tank provides the vessel and its specified fittings. A storage skid coordinates that vessel with transfer equipment, piping, valves, instruments and controls within an agreed package. The important distinction is the included operating function and supply boundary, not simply whether the tank stands on a steel frame.
How much of the tank capacity is usable?
Usable inventory is the volume between the normal upper operating inventory and the minimum operating inventory. It is not automatically the full gross capacity. In the illustrative 20 m³ example on this page, limits of 17 m³ and 3 m³ provide 14 m³ of usable inventory. Actual limits are project-specific.
Review the storage sizing exampleCan a storage skid refill while supplying the process?
Yes, when the receiving and delivery arrangement permits simultaneous operation and the product conditions allow it. Inventory increases only when refill flow exceeds simultaneous withdrawal. Equal flows maintain the current inventory; a lower refill flow leaves the tank drawing down.
Review the refill recovery calculationWhen is a dual-tank arrangement necessary?
Consider separate tanks when batches must remain isolated, one vessel needs cleaning while another supplies the process, or different products require separate storage. Continuous demand alone does not automatically require two tanks. Shared pumps, power and transfer paths should also be checked.
Can an existing tank be connected to a new transfer skid?
An existing tank can be considered after reviewing its condition, materials, connections, venting, design limits and available level information. The review should also include pump location, suction piping and site control interfaces. Nominal tank capacity alone is not enough.
Is secondary containment included with the skid?
It should be stated explicitly in the quotation. The scope may use integral containment, an agreed double-wall arrangement, local drip collection or a connection to site-provided containment. These are not interchangeable, so the required release scenario and effective volume should be defined.
Review the containment sectionCan the system be supplied for hygienic or pressure service?
These duties can be reviewed as separately specified configurations. Hygienic service requires defined product-contact, drainability, cleaning and documentation requirements. Pressure or vacuum service requires the corresponding design basis, component ratings and applicable conformity scope.
What information is needed for a storage skid quotation?
Start with the liquid, required usable inventory or supply time, delivery flow, available refill source and installation country. Add temperatures, composition, density, viscosity, outlet pressure, space restrictions, utilities and project requirements where known. A drawing is helpful but not required for an initial discussion.
Discuss Your Storage and Transfer Requirements
Tell us what you need to store, how the liquid arrives and where it must go. ChannelVessel can review the tank arrangement, usable inventory, transfer duty, controls and site interfaces together before the equipment scope is finalized.
Share the liquid name, concentration and relevant composition information when known.
If tank size is unknown, provide process consumption and the autonomy time you want to maintain.
Include downstream pressure or equipment duty where this information is already available.
Tell us whether liquid arrives from a tanker, IBC, bulk tank or upstream process.
Drawings, utility conditions and site photos can be added later if they are not ready yet.
Mark unknown information as “Not sure.” We can start from the operating requirement and identify what still needs to be confirmed before final design.

A useful proposal should connect storage capacity, refill behavior, pump duty, controls and site interfaces into one coordinated scope.
